Pickleball Court Paint Peeling and Blistering: What Is Causing It and What to Test Before You Recoat in Negros Oriental

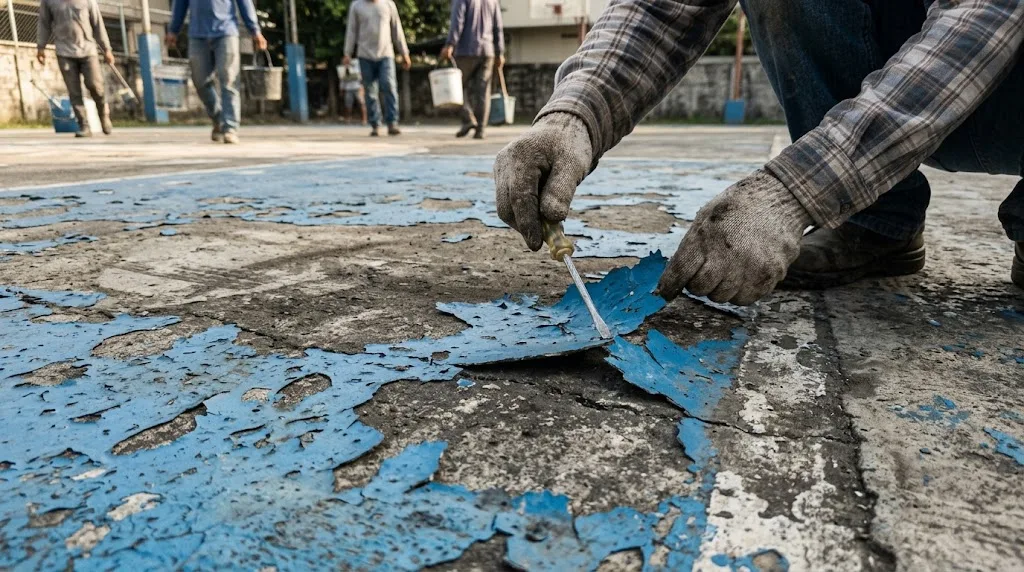

Close view of blistered and peeling blue paint on an old outdoor concrete court in the Philippines, a Filipino worker pressing a screwdriver under a flake

A flake lifted with a screwdriver tells you more than the colour does: look at the underside. Illustrative photo.

🏓
AEDO Engineering
AEDO Construction OPC, PRC-licensed civil engineers based in Negros Oriental with design services nationwide. Moisture, cure-time, preparation and weather limits below were read from manufacturer data sheets (Nippon Paint and Sika, Singapore and Malaysia sites) and the ASBA and USA Pickleball construction manual (2020 edition); AEDO's own working rules from a 2-court job in Manjuyod, Negros Oriental are labelled as AEDO practice. No peso rates are quoted except one public contract line. It is a troubleshooting guide, not a diagnosis of your court or a specification.

Short answer: in AEDO's experience, a failing court coating is usually a slab, preparation or weather problem more often than a bad-paint problem (that is our observation, not a survey). The data sheets we read put the same conditions on the slab and the day: moisture limit, cure time, surface finish, temperature and humidity. In our judgement, round blisters point first at moisture moving up through the slab. Peeling in strips points at a coat that never bonded: a smooth or sealed concrete face, laitance left on, or the wrong product. Chalky dust points at the texture coat. Puddles are a levels problem, and rust-coloured stains can mean corroding steel, which is structural. Before you pay for another coat, tick what you see in the checker below. It ranks the likely causes, names the test to run next, and gives one verdict: test before you recoat, repair then recoat, or slab problem: get it assessed.

This one is written for owners in Negros Oriental, from a barangay or LGU court in Bais or Tanjay to a resort, school or private club in Dumaguete, Sibulan or Manjuyod, who either have a court that is already failing or are about to paint a basketball slab or a new pad. One honest limit first: AEDO builds only in Negros Oriental. Everywhere else in the Philippines we design, seal, review remotely and check milestones of a contractor you hire. We name no climate figures here; the sequence and weather side is in our court painting schedule guide, and the layers and quantities in our court paint types guide.

Scorecard · By AEDO Construction

Court Coating Failure Checker

Tick every symptom you can see, then answer what you know about the slab. It is a screening scorecard: the weights are AEDO judgement, not taken from a standard, and it cannot see inside your slab. Treat the top cause as the first thing to test, not as a diagnosis. There is no cost figure here by design.

What you see (tick all that apply)
What you know about the slab and the job
Only the person who watched the pour can really answer this.
How to read it. The verdict row is the one decision; the ranked list below it is where to look first. Weights are AEDO judgement: a symptom adds points to the causes that can produce it, and your answers add or remove points (a barrier lowers the moisture score, an unknown raises it a little). Nothing here is a code limit. Where a limit exists, such as 28 days or a dew-point margin, it comes from a data sheet named in the text and Sources, and your own product's data sheet governs. This checker does not price a repair; for repainting cost per sqm see our court surface guide.
Have a failing court? Send us photos of the worst patch, one close-up of the underside of a lifted flake, the slab size, how old it is and what the painter used. We will tell you which test to run first and whether the slab itself needs a look. Outside Negros Oriental we design, seal and check remotely; we do not build there.

1. Read the Symptom

Start with what the failure looks like, because each pattern has a short list of usual suspects and a test that separates them. The last column says where the statement comes from, so you can tell sourced facts from AEDO judgement.

What you seeUsual causes, most likely firstFirst test or checkBasis
Round blistersMoisture vapour from below; primer put on in rising temperature (pin holes); too early on new concretePlastic-sheet test on bare slab; pour date; the painter's temperature logACI 302.2 guide; Sika data sheet; Nippon data sheets
Peeling in strips, clean concrete underneathNo bond: smooth or sealed face, laitance, curing compound or hardener, wrong product, moistureAsk what was sprayed on the slab and how it was prepared; pull-off strengthNippon and Sika data sheets; Sherwin-Williams article
Chalky dust, sand rubbing offTexture coat too thin or sand loaded only in the last coat; film weatheringCompare with the supplier's sample board; ask which coat carries the sandAEDO job plan (practice, not a published finding)
Sticky, never fully curedRain, dew or high humidity during cure; wrong mix or dilution; too cool or shadedCompare the painter's log with the data sheet limits; check the mix ratio on the data sheetNippon and Sika data sheets
Fading, patchy colourNormal wear; stains that bleached the colourCompare a worn lane with a corner that gets no playASBA and USA Pickleball manual
Cracks showing throughSlab shrinkage or movement; coating does not bridge cracksMap and measure cracks; look for a level step or growthManual; Nippon sport finish data sheet
PuddlesLow spot or too little fallFlood the clean court and string-line the birdbathsManual (birdbath, fall); Nippon data sheet
Rust-coloured stainsNet post or portable net hardware; or corroding rebar in the slabFind the source; if it comes from the concrete, stop and have it assessedManual; AEDO structural guide
White powder or crustSalts carried by water moving through the concreteDry-brush a marked patch and see if it returns after rain; plastic-sheet testCMHA technical note; AEDO damp wall guide

2. Moisture From Below and the Vapour Barrier

Concrete on the ground is never perfectly dry. Water from the subgrade, from a high water table or from a flooded pad moves up as vapour, and a coating film that does not let it out gets pushed off the slab. The American Concrete Institute's guide on slabs that receive moisture-sensitive coverings, ACI PRC-302.2-22 (first printed February 2023, replacing ACI 302.2R-06), says moisture-related problems with floor covering materials include blistering and delamination, and its scope names epoxy coatings and athletic flooring among the materials covered. It is written for floor coverings on slabs, mostly interior work, not for open-air court paint, so we use it for the mechanism and not as a court specification. We read the free preview of that guide (scope, contents and Chapter 1), not the paid body. What the preview does say is worth quoting in spirit: reaching a target moisture reading should not be the only test of a slab, because flatness, texture, cracking, curling, structural capacity, joints and whether the slab will stay dry matter too.

Figure: Vapour Lifts a Blister, and the Barrier Fix Section through the court slab, thicknesses schematic (not to scale) No vapour barrier 6 mil sheet under the slab Blister Concrete slab Gravel bed Damp subgrade Vapour builds under the film and lifts it Concrete slab Sheet on the gravel, only before the pour Damp subgrade Film stays flat, if every hole was patched A barrier lowers one cause. Weather, preparation and product problems are untouched by it.
Schematic. AEDO's Manjuyod job plan puts a 6 mil polyethylene sheet on the gravel bedding, under the slab, because an epoxy primer is a low-permeability film. That is AEDO's reasoning; the manual we read describes a polyethylene vapour retarder only for post-tensioned court slabs. The blister is drawn far larger than a real one.

What the manufacturers set as the moisture limit

There is no single number. Each coating states its own limit, and the limits differ because the products differ. These are the ones we read:

DocumentMoisture limit it statesAir and slab conditions it states
Nippon Paint Floor-Pro 107 SF damp-proof epoxy primer, data sheet TDS 0174, Aug 2020 (Singapore site)Concrete moisture content below 6%, or dried to 85% RH as per BS 8204; free from rising damp; waterproofed against negative ground-water pressureRelative humidity below 85%; substrate at least 3 degrees C above dew point; 15 to 40 degrees C
Nippon Paint Floor-Pro 702 sport floor finish (acrylic), TDS 0195, Aug 2020 (Singapore site)Below 4%, or dried to 85% RH as per BS 8204; free from rising damp; waterproofed against negative ground-water pressureRelative humidity below 85%; substrate at least 3 degrees C above dew point; 10 to 35 degrees C on concrete
Sika Sikafloor-161 HC epoxy primer, Sept 2026 edition (Malaysia site)Below 4% by weight (Tramex meter, CM or oven-dry method); no rising moisture on the polyethylene-sheet testRelative humidity 80% maximum; substrate at least 3 degrees C above dew point; 10 to 30 degrees C
Tnemec, article on concrete moisture testing (a US coatings maker)For most conventional floor primers, about 1.3 kg (3 lb) per 24 hours or 75 to 80% RH; specialty products tolerate up to about 9 kg (20 lb) per 24 hours and up to 99% RHNot stated on the page

Read the middle column twice. Two Nippon products from the same company differ (below 6% and below 4%), Sika asks below 4% by weight, and a damp-proof primer still insists on a slab free from rising damp. The takeaway is practical: ask the coating supplier for the moisture limit and the test method in writing before the slab is poured, because a barrier can only be laid before the pour. One more line from the Sika court sheet: its concrete-court preparation opens with "all concrete courts must have waterproof membrane" before the 28 days and the finish, and it adds an acrylic primer coat before the colour coats. It does not say what kind of membrane, so ask. Those four documents are all from outside the Philippines; we did not find a Philippine data sheet for a pickleball coating with these limits, and whether a given product is sold here is for the supplier to say.

The tests, and what each can and cannot tell you

We read the ASTM store pages (scope and summary only) and the three secondary descriptions; the standards themselves are paid, so the current edition's own wording on size and time is not confirmed. AEDO's "16 to 24 hours" sits inside that range (16 hours minimum per KTA-Tator and DeFelsko, 24 per Tnemec). Its 450 mm square is close to the 457 mm (18 in) sheet those pages give. We suggest the longer end, overnight, unless your coating maker names a time.

The vapour barrier under a new slab

The ASBA and USA Pickleball manual describes the barrier for post-tensioned concrete courts: a vapour retarder generally of a minimum of two layers of 6 mil polyethylene, laid in opposite directions, lapped and taped, taking care not to puncture it. It points to ASTM E1745 (a standard on water vapour retarders under slabs) and ACI 302.2R for more. The manual does not give a barrier spec for a reinforced slab. AEDO's Manjuyod slab is reinforced, and the job plan uses one 6 mil sheet on the gravel with the steel on wide-base plastic chairs (never rebar offcuts, which puncture it), 150 mm laps taped, turned up at the wall, and every hole patched before the pour. That is a design choice for that slab. For yours it is the designer's call, and it is a call made before the pour, not after the first blister.

AEDO's plan also says to pour straight onto the barrier with no sand blotter layer over it, citing ACI 302.2R. We could not confirm that from what we read (the free abstract, the contents and Chapter 1 only), and 302.2R-06 has since been replaced by PRC-302.2-22. We report it as AEDO practice and name what we did not read.

On an existing slab you cannot add one. The options are to stop the water at its source (fix the levels, drainage and fill: see our lot filling guide), to let the slab dry and prove it by test, or to ask the coating maker what moisture-tolerant system it supports. Sika's primer data sheet says that if moisture is above 4 percent by weight a cementitious system can go on as a temporary moisture barrier; Nippon's damp-proof primer is described as moisture-tolerant during application but still wants a slab free from rising damp. Those are product decisions with their own limits, not a repair you can improvise. If the real problem is water entering the wall or the base, see our damp wall and peeling paint guide, which says the same thing about walls: repainting over an active moisture source often peels again within a rainy season, in our experience. Our waterproofing guide prices flat roofs and exposed roof slabs, decks, gutters, tanks and pools, not ground-bearing court slabs, so do not read its rates across.

3. Too Early and Too Alkaline

The 28-day figure. Nippon's sport floor finish data sheet says new concrete must have cured at least 28 days, with a porous light-broom finish. Sika's Courtkote acrylic court coating data sheet says to allow new concrete to cure for 28 days. Those are the two sports-court documents we read, and AEDO's job plan uses the same figure, "28 days minimum". The manual gives a different shape for a post-tensioned slab: keep it moist for about seven days, then allow a further 21 to 38 days. Our concrete mix ratio guide asks for at least seven days of continuous curing, which agrees with the first part.

Time is not dryness. The manual's indoor chapter says concrete cures two ways, strength curing between 21 and 45 days and moisture curing that depends on conditions and is hard to gauge, so it is usually determined by testing. For indoor sports floors it asks for concrete in place at least 60 days and tested below the manufacturer's limit. That is an indoor-floor rule, not an outdoor acrylic one, but it shows why a calendar alone does not clear a slab. A slab on well-drained ground and a pad built up on fill over a wet site are not the same slab on day 28.

Alkalinity. Fresh cement is strongly alkaline. A resin supplier's leaflet (Synthomer) says Portland cement mixed with water reaches pH 13 to 14 and causes alkali burn and discolouration when painted. A Sherwin-Williams article on peeling concrete floors aims for a pH of 7.0 to 10.0 after cleaning and lists oil-based coats on bare, unetched, uncured concrete among seven causes of peeling. The manual's indoor chapter lists alkali among the bond-breakers a slab must be free of before a resilient athletic floor goes on, and the ACI preview lists a chapter on concrete pH testing, but we read no pH figure from either. AEDO's job plan says new concrete pH 12 to 13; we could not match that exact range to a source, so treat all of these as showing the direction, not as a limit. The limit that counts is the one on your coating's data sheet.

4. Slab Finish, Preparation and Sealers

This is where most "peeling in strips" starts. The data sheets are specific:

What that means for a polished slab. Our surface guide prices the system AEDO used in Manjuyod: a machine-troweled and polished slab, then an epoxy primer and rubberized top coats. A troweled or polished face is the opposite of the broom finish the acrylic data sheets ask for, and the primer data sheets ask for mechanical preparation. AEDO's own job plan says so too: tell the polishing subcontractor not to apply a densifier or hardener, because a densified surface will not take the primer, and either leave a lightly abraded finish or budget a light diamond grind before priming. Whether a polished face is acceptable for a given product is the coating maker's decision, so get it in writing for your product before you polish.

5. Weather on the Day

Each data sheet sets a window. Outside it you can get a sticky film, a film that blisters, or a coat that never bonds.

SourceWhat it says about conditions
Nippon sport floor finish (acrylic)Relative humidity below 85%; at least 3 degrees C above dew point; do not apply below 10 degrees C ambient, above 35 degrees C on the concrete, or when rain is imminent; best in the cool morning or evening; second coat after a minimum of 4 hours depending on weather
Sika Sikafloor-2045 Courtkote (acrylic)Minimum 4 hours between coats; court ready for use 24 hours after the final coat; protect the whole application and curing from rain
Sika Sikafloor-161 HC (epoxy primer)Relative humidity 80% maximum; at least 3 degrees C above dew point; protect from damp, condensation and direct water for at least 24 hours; apply during falling temperatures, because on porous concrete during rising temperatures air rising from the pores can leave pin holes, and if pin holes remain the next layer can blister
ASBA and USA Pickleball manualPatching at at least 55 degrees F (about 13 degrees C) with no precipitation in the immediate forecast; each coat dry before the next; at least 72 hours for an acrylic surface to cure before play

Two points follow from those lines. First, a slab sitting in strong sun can be well over the air temperature, and Nippon sets a 35 degrees C limit on the concrete, not the air. Second, the pin-hole note explains a blister that is not moisture from below at all: a primer put on while the slab warms up can trap air and blister the coat above it. Both are things an applicator can plan around with a thermometer and a hygrometer, and both are things you can ask to see in a daily log.

For a court in Negros Oriental the practical consequence is simple: the painting date is a weather decision, and the right contractor can tell you the limits for their product and what they do when it rains mid-coat. We deliberately print no rainfall or climate figures here. How the cure and recoat holds fit into a real programme, with PAGASA data, is in our painting schedule guide.

6. Wrong Product and Dusting

Wrong product. Sherwin-Williams puts unsuitable coating selection for the floor's wear and exposure at the top of its seven causes of peeling concrete. A sports-court product is made and tested for it: Nippon's sport floor finish says it is designed for sport courts and claims resistance to ponding water for 48 hours; Sika's Courtkote is sold as a hardcourt sports surfacing system. AEDO's own list of failure causes includes a wall or roof elastomeric used on a trafficked court. No standard we read says that, so treat it as AEDO field judgement. The same logic shows up in walls: our painting cost guide notes Boysen publishes its masonry putty for interior use only, and that using it outside is a common reason exterior repaints peel in sheets. The test is simple: read the can, then the data sheet's application areas. If neither says sports court or trafficked floor, ask why that product is on your slab.

Dusting. AEDO's Manjuyod plan says silica sand only in the final coat, over a smooth substrate, is the usual cause of first-season dusting, and says to consider a lighter silica loading in the first top coat as well as the working loading in the second. That is AEDO practice, not a published finding. For comparison, Nippon's Malaysian professional page describes its anti-slip epoxy hybrid system as applied with non-skid sand in the intermediate coat. If your court sheds sand, ask the applicator which coat carries it and how much, and compare against the supplier's sample board.

7. Cracks, Puddles, Rust, Salts and Fading

8. The Repair Route and Prevention

The order that saves money. Repainting over an unfixed cause repeats the spend. For scale, AEDO's Manjuyod contract paint line was PHP 78,158 on a 352.63 sqm pad, PHP 221.64 per sqm (already public in our surface guide). That is a contract line, not a recoat price, and we do not publish a repair price for failed courts; it only shows the size of money that is thrown away each time a coat goes over a cause nobody fixed.

  1. Stop and read the failure. Photograph the worst patches and the underside of a lifted flake: wet, white, chalky, rusty or clean?
  2. Test the slab, not the paint. Plastic-sheet test first, then RH or calcium chloride only if your coating data sheet sets that limit. A failed test sends you back to the water source, not to the painter.
  3. Fix the cause. Levels and drainage for puddles; the slab and its supports for rust and settlement; mechanical preparation for bond failures.
  4. Remove the failed film back to sound edges. The data sheets we read prepare by blasting, scarifying or grinding, not by painting over a loose film.
  5. Patch and level. Flood-test the clean court again; patch compounds and crack fillers must suit your coating.
  6. Recoat inside the weather window of your data sheet, with the log kept, and protect the cure from rain.

For a new court, close each cause before it happens. This list mixes sourced items with AEDO practice, marked as such:

  1. Get the coating data sheet before the slab design is final, because the moisture limit and finish it asks for decide what happens before the pour (sourced: data sheets).
  2. Decide the vapour barrier before the pour and protect it from punctures (manual for post-tensioned slabs; AEDO practice for reinforced).
  3. Cure moist for about seven days with no curing compound unless the coating maker approves it (manual; Nippon; Sika).
  4. Ask for a broom or other profile finish per the maker, and no densifier or hardener (data sheets; AEDO plan).
  5. Wait at least 28 days and then prove dryness by the test the maker names (data sheets; days alone are not proof).
  6. Fix the fall at 0.83 to 1.00 percent before the forms go in (manual).
  7. Require a daily log of temperature, humidity, dew point and rain, and a sample board on your own slab (data sheets; AEDO practice).

Common mistakes. Repainting before testing. Treating the flake as the problem instead of the slab. Spraying a sealer or densifier on a slab that will be painted. Counting 28 days on the calendar and skipping the moisture test. Painting at the first dry afternoon after a wet week. Using a wall paint because it is cheaper per pail. Assuming a "waterproof" coat on top will hold water back from below.

9. AEDO's Manjuyod Rules: Sourced or Not

AEDO's job plan for a 2-court open court in Manjuyod, Negros Oriental, has its own list of working rules for the coating. We are not asking you to take them on trust. Here is each one against what we could read this session:

AEDO working ruleWhat we could confirmWhat we could not
28 days minimum before primingBoth sports-coating data sheets we read (Nippon and Sika) ask for 28 days; the manual has 7 days moist plus 21 to 38 days for post-tensioned slabsThat 28 days alone proves a slab dry. It does not: a moisture limit is tested
6 mil polyethylene barrier on the gravelThe manual describes 6 mil polyethylene, generally two layers, under post-tensioned court slabsA barrier spec for reinforced slabs in what we read. One sheet is AEDO's design choice
No sand blotter over the barrier (ACI 302.2R)ACI PRC-302.2-22 replaced 302.2R-06; the free preview lists a chapter on vapour retarder locationThe blotter statement itself: we read the abstract, contents and Chapter 1 only
ASTM D4263 sheet test, 450 x 450 mm, 16 to 24 hoursThe test exists and ASTM lists D4263-24 as active; an 18 in (457 mm) sheet, at least 16 hours (KTA-Tator, DeFelsko) or at least 24 hours (Tnemec, 2005 edition). AEDO's 16 to 24 hours sits inside that rangeThe current edition's own text (paid); the exact 450 mm size (the pages we read say 457 mm)
No densifier or hardener before primingDirection supported: Nippon (hardeners, curing membranes), Sika (curing membrane, additives, surface treatments), Sherwin-Williams (hardeners added to concrete) and the manual (liquid curing agents, sealers under indoor floors) all warn against such treatmentsThe word "densifier" in any page we read; that a lightly abraded finish is enough without grinding: depends on the product
New concrete pH 12 to 13Strong alkalinity of fresh cement is confirmed; Synthomer gives pH 13 to 14 for cement mixed with waterThe 12 to 13 range. Sherwin-Williams aims for 7 to 10 after cleaning
Silica only in the last coat causes first-season dustingNothing; Nippon's anti-slip system uses sand in an intermediate coatAny published finding. It is AEDO practice
Wall or roof elastomeric on a trafficked court failsSherwin-Williams lists unsuitable coating selection as the first cause of peelingA standard naming elastomerics. It is AEDO field judgement
Vapour blistering is the most common court coating failure in this marketNothingAny survey. It is AEDO's observation, not a statistic

That job's coating results are not part of this article. The finish lines (slab, polish and paint) and their rates are in the surface guide.

10. Painting or Building in Negros Oriental

An open-air court takes sun and rain, so every point above is live: the barrier and the cure plan belong in the design, the weather limits belong in the contract, and the test belongs before the first coat. If you are in Dumaguete, Bais, Sibulan, Tanjay, Manjuyod or a neighbouring town and want one firm to take the court from slab to lines, that is what design-build is for, and construction from your plans covers a court you have already designed. Our Dumaguete and Bais pages describe the area. Our construction page lists a pickleball court in Manjuyod as work currently on site.

On the checking side, a Single Milestone Check from PHP 7,500 per visit is one site visit tied to a critical stage; for a court the stages that matter are before the pour (barrier laid and undamaged, chairs, levels) and before final payment (coating log, sample board). Our PHP 5,000 structural assessment lists foundation and settlement, columns, beams and slabs, and crack pattern and width in its scope, and the report is a structural finding. It does not list coating chemistry or moisture testing, so for a court slab we would confirm that a visit fits before you book. Outside Negros Oriental we design, seal and check remotely; we do not build there. See also what a structural assessment report contains and structural engineer fees.

Where These Figures Come From

Moisture, cure, preparation and weather limits are from the manufacturer data sheets named in the text (Nippon Paint Singapore and Sika Singapore and Malaysia sites) and from the ASBA and USA Pickleball manual, Pickleball Courts: A Construction and Maintenance Manual, 2020 edition. ASTM, ACI and ICRI documents are paid; we read only the free scope pages, abstract, preview and contents named in Sources. Tnemec, Sherwin-Williams, Synthomer, KTA-Tator, DeFelsko and the CMHA are secondary manufacturer or industry pages. AEDO's own rules come from the Manjuyod job plan and are labelled as AEDO practice. The checker's weights are AEDO judgement. No Philippine standard we found sets a limit for a pickleball court coating, and we found no Philippine data sheet for one. The only peso figure is the public Manjuyod contract line.

Frequently Asked Questions

Why is the paint on my pickleball court blistering?

The first thing to rule out on concrete is moisture moving up through the slab and lifting a film that cannot let it out; AEDO's experience is that this is the usual culprit, though we have no survey to prove it. ACI's guide on slabs under moisture-sensitive coverings lists blistering and delamination among moisture problems, and its scope includes epoxy coatings and athletic flooring (it is written for floor coverings, not specifically for outdoor courts). Other causes are coating too soon on new concrete, putting a primer on during rising temperature so it pin-holes, and applying in humid or dewy weather. Test the slab for moisture before you repaint.

Why does paint peel off a concrete court in strips?

Strip peeling usually means the coat never bonded to the concrete. The manufacturer data sheets we read ask for laitance to be removed, a pull-off strength of at least 1.5 N/mm2, and no curing membranes, hardeners or surface treatments under the coating. A smooth troweled or polished face, a sealer or densifier, the wrong product, or moisture from below can each do it. Find out what was applied to the slab and how it was prepared.

How long must new concrete cure before painting a pickleball court?

The two sports-coating data sheets we read, Nippon Paint's sport floor finish and Sika's Courtkote, both ask for at least 28 days on new concrete. The ASBA and USA Pickleball manual describes about 7 days of moist curing then a further 21 to 38 days for a post-tensioned court slab. Days are not proof of dryness: the data sheet of your coating also sets a moisture limit that has to be tested.

How do I test a concrete slab for moisture before painting?

The simplest test is the plastic sheet method, ASTM D4263: a sheet is taped to the clean slab and checked for moisture afterwards; the pages we read give a minimum of 16 hours, 24 hours or 48 hours depending on the source, so use the time your coating maker names. It only shows whether moisture is present in the upper slab. Quantitative tests are an in-slab relative humidity probe (ASTM F2170) and calcium chloride (ASTM F1869). Use the method and limit your coating data sheet names.

Can I just repaint a peeling pickleball court?

Not until you know why it peeled. Paint laid over an active cause fails again, and the manual we read says repaired blemishes lead to a speckled look. If the cause is preparation or weather, fix that, remove the failed film back to sound edges and recoat inside the data sheet's weather window. If it is moisture or a moving slab, repainting only hides the problem for a while.

Does a vapour barrier under the slab stop court paint from blistering?

It lowers the risk but does not remove every cause. The manual describes a polyethylene vapour retarder under post-tensioned court slabs, generally two layers of 6 mil sheet, lapped and taped. A barrier can only go in before the slab is poured, and a punctured one defeats its purpose. Blisters can also come from weather, preparation and product problems that a barrier does not touch.

Sources

Manuals, data sheets and standards pages we read this session (all returned HTTP 200). External links open in a new tab.

All data sheets are from outside the Philippines; we found no Philippine data sheet for a pickleball court coating and no Philippine standard that sets a limit for one. We could not confirm from the standard itself AEDO's 16 to 24 hour sheet test (secondary sources agree with the range), and we could not confirm its no-sand-blotter citation, its pH 12 to 13 range, or its dusting and elastomeric rules from a source; they are labelled AEDO practice. This article is general information, not a diagnosis of your court.

Court Paint Failing, or About to Paint?

Send photos of the failure, one close-up of a lifted flake, the slab size and age, and what the painter used. A licensed engineer will tell you which test to run first and whether the slab itself needs a look.

  • Likely cause ranked and the test to run before you recoat
  • Barrier and cure plan reviewed before a new court is poured
  • Design-build for courts in Negros Oriental, from slab to lines
  • Design, sealing and remote checks nationwide; we build only in Negros Oriental
