Dental Clinic Fit-Out Cost Philippines 2026: Chairs, X-Ray, Permits

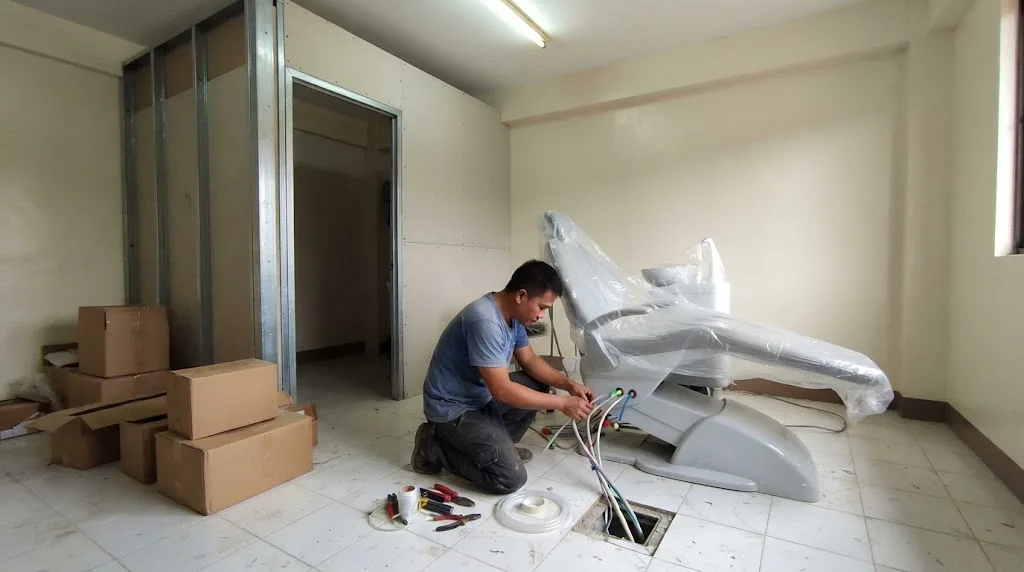

A small dental clinic being fitted out, with a new dental chair still wrapped in plastic and a technician connecting the water and suction lines at its base

The chair arrives last. The water, drain, air and suction lines under it had to be in the floor weeks before. Illustrative photo.

🦷
AEDO Engineering
AEDO Construction OPC, PRC-licensed civil engineers based in Negros Oriental with design services nationwide. X-ray rules are read from DOH AO 124 s. 1992 and the FDA CDRRHR citizen's charter and dental X-ray forms; DOH licensing from AO 2020-0047; exits from the 2019 Revised IRR of the Fire Code. Fit-out bands are published 2026 figures; every dental-specific peso rate is an AEDO planning estimate and is labelled as one.

Short answer: a dental clinic starts from the same published 2026 commercial fit-out bands as any clinic, about ₱10,000 to ₱20,000 per sqm basic and ₱20,000 to ₱35,000 mid-range, then adds what only dentistry needs: four utility lines under the floor to every chair, a compressor and suction room, a sterilization area laid out dirty-to-clean, and shielding for the X-ray. A 90 sqm, three-chair, mid-range clinic on a ground-floor street unit with one intraoral X-ray comes to roughly ₱2.4M to ₱4.4M in fit-out works before the chairs and equipment. The X-ray is where owners get caught out. No X-ray facility may operate without authorization (DOH AO 124, s. 1992), and the FDA treats an intraoral unit and a panoramic unit differently.

This post covers what's different about a dental clinic. For the general clinic questions, budget by scope and whether a leased space can pass at all, read our clinic fit-out cost guide and the clinic compliance checklist first. The calculator below turns your chair count, floor area and X-ray plan into a cost band, a space check and a utility checklist.

Free Tool · By AEDO Construction

Dental Clinic Fit-Out Cost Estimator

Base bands are published 2026 fit-out figures. The 8.63 m² per chair benchmark is from DOH AO 2020-0047. Every dental-specific peso rate, the room-size allowances and the mall premium are AEDO planning estimates, not code values or quotations.

Panoramic here covers pano, ceph and CBCT
Malls add accredited contractors, night work and landlord MEP standards
Upper floors mean coring the slab for chair drains
What this is and isn't. The base band is the published range for commercial fit-outs in 2026 and already covers ordinary partitions, flooring, ceilings, lighting, aircon and plumbing; the dental lines are what goes on top. The space check uses AEDO room allowances and compares the operatories with the DOH figure for dental clinics inside primary care facilities. Dental chairs, the compressor and suction machines, the autoclave, the X-ray unit and all other equipment are not in these numbers, and neither is the X-ray shielding design fee.
Found a unit? Send us the floor plan, your chair count, the chair model you're buying and whether you'll have a panoramic. We'll lay out the operatories, route the four chair lines back to a plant room, and tell you if the slab or the electrical service is the problem before you sign.

1. Where the Money Goes

Think of a dental clinic as two budgets. The first is an ordinary clinic fit-out: partitions, ceilings, floors, lights, aircon, toilets. The second is the dental layer, which is mostly services you'll never see once the clinic opens. Compare contractor quotes layer by layer, not as one number.

By finish level₱ per sqmBy location₱ per sqm
Basic / cosmetic10,000–20,000BGC / Makati CBD25,000–45,000+
Mid-range20,000–35,000Ortigas / Mandaluyong20,000–38,000
High-end / premium35,000–45,000+Quezon City / Alabang15,000–32,000
Mall tenancy: add about 15–25% for the same scopeCebu / Clark / Iloilo12,000–28,000

Those are the published 2026 bands (Alphabuild's Manila fit-out guide, with J.I. Raymundo Builders giving a ₱20,000–35,000 planning range) that our office, clinic and pharmacy fit-out guides also use. They're written for offices, so a dental clinic with its wet operatories and services sits in the upper half of whichever band you pick. Dental equipment is not in them. Neither is anything in the next table.

Dental-specific line (AEDO 2026 planning rates)Rate
Chair utility package: water, drain, compressed air and suction under the floor to the chair box, plus a dedicated circuit₱45,000–₱90,000 per chair
Upper floor only: slab coring, sleeves and leak protection at each chair₱15,000–₱30,000 per chair
Compressor and suction room: enclosure, sound lining, ventilation, exhaust to outside, mains₱90,000–₱200,000 lump sum
Sterilization area: dirty and clean counters, two sinks, autoclave circuit, exhaust₱120,000–₱250,000 lump sum
Intraoral X-ray: shielding to the room it's used in, warning sign, dedicated circuit₱50,000–₱150,000
Panoramic room on top of that: shielded walls and door, viewing window, circuit₱180,000–₱400,000
Contingency10%

The X-ray lines cover the construction only. The shielding design itself, the equipment, and the FDA fees are separate. The ranges are wide because the room, the unit and what's next door all change the answer, and that's covered in Section 5.

2. Four Lines Under Every Chair

A dental chair isn't furniture. It's a plumbing and electrical fixture that happens to recline. Most chairs take their services through a utility box in the floor at the base of the chair, and that box needs four lines plus power:

The box location is fixed by the chair maker's installation template, not by the architect. Get the template for the exact model before any floor work is priced. Buy the chair after the screed is poured and its box may not land where the pipes come up. The fix is breaking a new floor.

Figure: How a Dental Chair Is Serviced Four lines under every chair, two of them back to the plant room Dental chair chair floor box Plant room ventilated, sound-lined Compressor Suction compressed air suction (vacuum) water, with shutoff drain, sloped to the building drain suction exhaust to outside to supply to drain Under-floor run: a trench, a raised screed, or the ceiling space below on an upper floor. Layout practice, not a code rule.
The chair is the last thing installed and the first thing designed. Its floor box sets where four lines come up. Air and suction run back to one plant room; water and drain tie into the building's own lines.

How those lines get to the chair depends on the floor:

The drainage itself follows the National Plumbing Code and goes on a plumbing permit drawn up by a Master Plumber; our plumbing code guide covers that side.

3. The Compressor and Suction Room

The compressor and the suction unit are the two machines patients should never hear. Put them in the operatory corridor behind a thin board wall and every patient will. What we plan for, as practice rather than code:

In a mall, ask the landlord early where the plant room is allowed to exhaust. Some malls won't let you vent to the corridor or the service area, and the answer may move the room.

4. Sterilization: Dirty to Clean, One Way

The sterilization area is the one room where layout is about infection control rather than looks. Used instruments come in dirty and leave sterile, and the room should never let those two cross. We lay it out as a straight run in one direction:

Figure: Sterilization Area Flow Instruments move one way. Dirty never crosses back into clean. Receiving used trays in Clean sink, rinse, dry Inspect, pack clean counter Autoclave own circuit, vented Sterile storage closed, dry Dirty zone Clean zone Infection-control layout practice. We found no Philippine building code clause that sets it.
A straight line is the cheapest way to get this right. If the room is small, keep the order and turn the corner; what matters is that the dirty counter and the sterile shelf never swap sides.

The construction items that follow from that layout: two sinks rather than one, so rinsing never happens where packs are wrapped; a dedicated circuit for the autoclave; an exhaust fan, because autoclaves put heat and steam into a small room; and closed storage for sterile packs away from the sink splash. For reference, the equipment list DOH annexes to AO 2020-0047 for dental services in a primary care facility includes a 20 L autoclave and a dental unit and chair with compressor, which gives a sense of the sizes to plan counter space around.

5. Dental X-Ray: What the FDA Actually Requires

This is the part people get wrong, usually by treating the X-ray as just another piece of equipment. It isn't. DOH Administrative Order No. 124, s. 1992, the rules on X-ray facilities, is short on this point: no X-ray facility may operate without a valid license (Section 7.2). It lists the dental X-ray facility as its own class, hospital-based or free-standing (Section 6.1). An unlicensed facility has to stop operating, and the regulator can disconnect a high-tension lead and seal the machine (Section 21.2).

The regulator today is the FDA's Center for Device Regulation, Radiation Health and Research (CDRRHR). Its citizen's charter (the February 2021 edition we read) splits dental units into two tracks:

UnitAuthorization (FDA CDRRHR charter)What the charter lists
Periapical (intraoral)Certificate of Facility Registration (CFR)Proof of business name; subscription to personal dose monitors (TLD or OSL); PRC licenses of dentists and X-ray technologists; training certificate of the radiation protection officer from a CDRRHR-recognized course
Panoramic, cephalometric, CBCTLicense to Operate (LTO)The same documents plus a machine calibration certificate signed by the service engineer, and a pre-licensing inspection before the LTO is issued

Fees are per machine, by the unit's mA range. For the lowest bracket, 100 mA and below, the charter and the FDA's dental X-ray checklist both list ₱810 for an initial application and ₱410 for renewal, plus a 1% legal research fee. Late renewal costs more. Check the current charter before you file, since fee schedules and forms get revised.

What that means for the fit-out:

Order of Work for an X-Ray Room

Pick the unit first. Get the shielding designed for that unit and that room. Build the shielded walls and door. Install and calibrate. Then file with CDRRHR, and for a panoramic, pass the pre-licensing inspection. Buying the machine last is how clinics end up rebuilding a finished room.

6. Does DOH License a Dental Clinic?

It depends on what the clinic is, and the honest answer is less tidy than most online guides make it sound. Here's what we could read in the primary documents:

So: if the dental clinic is part of a medical clinic or primary care facility, plan for the DOH License to Operate and its floor-plan review. If it's a dentist-only practice, confirm with your DOH Center for Health Development before you assume either way. The X-ray is not part of that question. It always needs FDA authorization.

One more thing owners hear about: DILG Memorandum Circular No. 2016-170 advises LGUs that medical and dental clinics used for check-ups and procedures are exempt from the Mayor's or business permit, provided the professionals pay their professional tax. That circular is about the Mayor's permit only. It doesn't touch the building permit, the plumbing and electrical permits, or the Fire Code, all of which still apply to the fit-out.

7. PD 856 and the Sanitary Permit

People expect the Code on Sanitation, PD 856, to have a dental chapter. It doesn't. Its chapters cover food establishments, markets, laundries, schools, industrial hygiene, swimming pools, beauty parlors, massage clinics, hotels, sewage, refuse and a few more. The sanitary permits it spells out are for those establishments. There's no chapter for medical or dental clinics.

That doesn't mean your city health office won't ask for one. Many LGUs issue sanitary permits under their own ordinances. Ask the city or municipal health office what it requires for a dental clinic before you plan the opening date. For the fit-out, what matters from sanitation is what you'd build anyway: working toilets and handwashing, a drain for every wet point, and a place for sharps and clinical waste to wait for the hauler.

8. Fire Code: A Dental Clinic Is a Business Occupancy

The 2019 Revised IRR of the Fire Code settles the category directly. Its occupancy classification lists offices for lawyers, doctors, dentists and other professionals under business. Health care occupancy in the RIRR is for people mostly incapable of self-preservation, such as hospitals, nursing homes and birth centers, which a dental clinic is not. The business rules in Section 10.2.16 are what apply to a typical clinic:

Requirement (Fire Code 2019 RIRR)Rule
Occupant load, §10.2.16.1 C1 person per 9.3 m² of gross floor area
Number of exits, §10.2.16.2 D.1Not less than 2 separate exits on every storey
Single exit allowed, §10.2.16.2 D.3Room or area under 100 persons, exit discharging directly outside at the level of exit discharge, total travel 30 m or less
Common path of travel, §10.2.16.2 E.330 m in a single tenant space of 30 persons or fewer; 23 m otherwise without sprinklers
Travel distance to an exit, §10.2.16.2 F46 m unsprinklered; 61 m with approved, supervised sprinklers
Emergency lighting, §10.2.16.2 H.2Where the building is 2 or more storeys above exit discharge, or 50 or more occupants above or below it
Wall and ceiling finish, §10.2.16.3 BClass A or B in exits and exit-access corridors; A, B or C elsewhere
Fire alarm, §10.2.16.3 DFire alarm system where the building is 2+ storeys above exit discharge, 50+ occupants are above or below it, or 300+ in total (existing buildings: 100 and 1,000); otherwise a manual fire alarm system (D.4)

A 90 m² clinic works out to about 10 people at 9.3 m² each, so the single-exit route is usually available on a ground floor. On an upper floor it depends on the building's stairs, which is the landlord's system, not yours. Our fire exit guide works through the stair math. Two dental-specific habits of ours, not code clauses: the compressor room is a machine room, so keep it clear of storage, and keep the oxygen cylinder, if you have one, secured and away from the autoclave's heat.

9. Electrical Load

A dental clinic's load is lumpier than an office's. Every chair has its own circuit. The compressor and the suction unit start under load, the autoclave pulls hard for each cycle, and a panoramic unit wants a clean, dedicated supply. Add the aircon for a room full of closed operatories and a small unit's panel fills up fast.

We don't put kVA figures on this page because they come from the nameplates of the exact models you buy. The right sequence is: pick the chair, compressor, suction, autoclave and X-ray models, get their nameplate loads, and have an electrical engineer build the load schedule against the unit's service rating before you sign the lease. Our electrical service sizing guide shows how that schedule is built. If the unit only has a small single-phase supply, find out now whether the building can give you more.

10. Accessibility and the Building Permit

A dental clinic is a place patients with disabilities will use, so BP 344 applies. The item that most often costs space in a small clinic is the accessible toilet: the 2024 Revised IRR puts the 1,800 × 1,800 mm turning space outside the cubicle and the grab bar top at 750 mm. Our accessible toilet guide has the full layout. At least one operatory also needs a clear door and space for a wheelchair to come alongside the chair.

The fit-out itself needs a building permit with its electrical and plumbing components, like any other renovation; see our commercial fit-out permit guide. On occupancy, Table VII.1 of the 2004 Revised IRR of PD 1096 lists "clinic" among the uses under Group E, business and mercantile, so a clinic moving into an ordinary shop or office unit usually stays in the same group. A clinic going into a house or a residential unit is a different story; our change of occupancy guide explains that route. The landlord's own fit-out approval runs alongside all of this.

AEDO's role on a dental clinic fit-out. Nationwide, AEDO lays out the operatories around your chair's installation template, routes the water, drain, air and suction back to a plant room, checks the slab where cores are needed, and prepares the complete design package (architectural, structural, electrical and plumbing), with the X-ray room drawn to the shielding design your qualified expert provides. Outside Negros Oriental we can also provide remote oversight of the contractor you hire locally. In Negros Oriental, AEDO designs and builds it.

Where These Figures Come From

X-ray licensing is read from DOH AO 124, s. 1992 (Sections 6.1, 7.2, 7.3, 8.1 and 21.2), the FDA CDRRHR citizen's charter (February 2021 edition, CFR and LTO sections) and the FDA's dental X-ray application form and checklist. DOH licensing and the 8.63 and 8.26 m² per chair figures are from DOH AO 2020-0047 and its annexes. The Mayor's permit point is from DILG MC 2016-170. PD 856's chapter list is from the decree's text. Fire Code rules are from the 2019 Revised IRR of RA 9514, Division 3 classification and Section 10.2.16. The Group E listing is from Table VII.1 of the 2004 Revised IRR of PD 1096. BP 344 figures are as verified in AEDO's accessibility guides. Fit-out bands are published 2026 figures. Every dental-specific peso rate, the room allowances, the 4.5 m² panoramic room and the mall premium are AEDO planning estimates.

Frequently Asked Questions

How much does it cost to fit out a dental clinic in the Philippines?

Start from the published 2026 commercial fit-out bands: about ₱10,000 to ₱20,000 per sqm basic, ₱20,000 to ₱35,000 mid-range and ₱35,000 to ₱45,000 or more high-end. A dental clinic then adds its own lines on AEDO's 2026 planning rates: utilities under the floor to every chair, a compressor and suction room, a sterilization area and, if you have one, the X-ray shielding. A 90 sqm, three-chair, mid-range street-front clinic on the ground floor with one intraoral X-ray comes to roughly ₱2.4M to ₱4.4M in fit-out works, before dental chairs, the X-ray unit and other equipment.

Do I need a license to use a dental X-ray in the Philippines?

Yes. DOH Administrative Order No. 124, s. 1992 says no X-ray facility may operate without a valid license, and it names the dental X-ray facility as its own class. Today the authorization comes from the FDA's Center for Device Regulation, Radiation Health and Research (CDRRHR). Under the FDA citizen's charter we read, a periapical (intraoral) unit gets a Certificate of Facility Registration, while panoramic, cephalometric and CBCT units need a License to Operate that includes a pre-licensing inspection. Both need personnel dose monitoring, a trained radiation protection officer and PRC licenses on file. Fees are per machine by mA range, starting at ₱810 for an initial application for units of 100 mA and below.

How thick should the walls of a dental X-ray room be?

We don't quote a thickness, because none of the Philippine documents we read for dental X-ray facilities sets one. The shielding depends on the unit, its workload, the room size and what is on the other side of each wall. Have a qualified expert do the shielding design to CDRRHR's requirements before the walls are built, and build it before the finishes go on. Retrofitting lead into a finished wall costs far more.

Does a stand-alone dental clinic need a DOH License to Operate?

Confirm it with your DOH Center for Health Development. DOH Administrative Order No. 2020-0047 requires a DOH License to Operate for primary care facilities and lists dental services as one of their ancillary services, but a primary care facility is defined around medical consultation. We did not find a DOH order that requires a separate License to Operate for a private clinic that does dentistry only. The X-ray is a different matter: that always needs FDA authorization.

How much space does each dental chair need?

The only Philippine figure we found is in DOH Administrative Order No. 2020-0047, for a dental clinic inside a licensed primary care facility: at least 8.63 square metres per dental chair, covering the chair, movement of people and passage of equipment. The floor-plan checklist annexed to the same order says 8.26 square metres per chair, so the order is not consistent with itself. For planning we use about 10 square metres per operatory, which clears both.
