A Restaurant Kitchen Fit-Out Isn't a Smaller Office Fit-Out

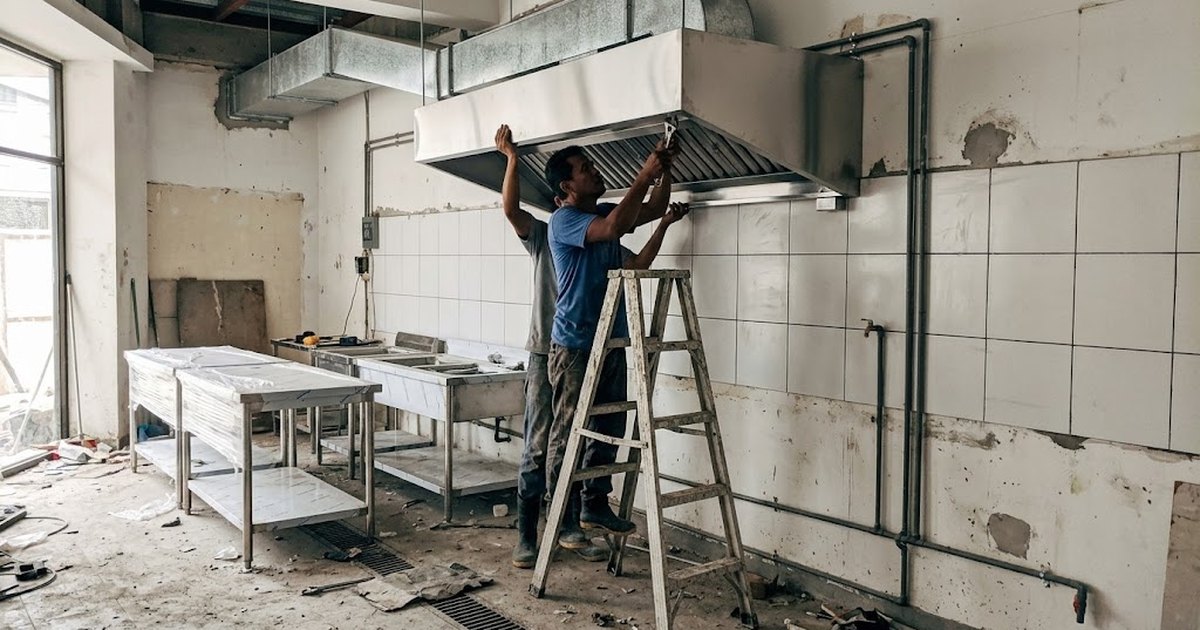

Workers installing a stainless steel exhaust hood in a commercial kitchen fit-out

The exhaust hood and duct run take a big share of a commercial kitchen's fit-out cost. Illustrative photo.

🏗️
AEDO Engineering
AEDO Construction OPC, PRC-licensed civil engineers. Cost bands are quoted from published 2026 fit-out guides and labelled with their source. We don't process LPG or food-business licensing ourselves, which sits with the Fire Marshal, DOE/DTI and your LGU.

Short answer: a commercial kitchen fit-out uses the same published 2026 cost bands as any other commercial fit-out, but a full-cook kitchen lands toward the higher end of those bands because of three systems an office never needs: an LPG gas line and storage, an exhaust hood with makeup air, and a grease trap ahead of the sewer or septic connection. Each of those carries its own permit, and none of them are optional line items you can value-engineer away.

Operators budgeting off an office fit-out quote per square metre usually get surprised twice: once when the mechanical contractor prices the hood and exhaust run, and again when the Fire Marshal's office asks for a separate clearance for the LPG installation before they'll sign off occupancy.

Free Scope Estimator · By AEDO Construction

Commercial Kitchen Fit-Out Scope & Cost Range Estimator

Bands are the published 2026 figures from Alphabuild and J.I. Raymundo Builders, written for office fit-outs. The full-cook uplift is AEDO's own estimate for the added kitchen M&E scope, not a cited market figure.

What this is and is not. A scope-and-range sense check using published fit-out bands plus AEDO's own kitchen uplift, not a quotation. It excludes kitchen equipment, hood and exhaust ductwork priced separately by an MEP contractor, furniture, and professional fees.

Approvals to budget time for, not just money

  • Building permit alteration and, on completion, occupancy for the change in use
  • Fire Safety Clearance for the LPG installation, separate from the building's general FSIC
  • DOE/DTI Safety Compliance Certificate for the LPG cylinders or tank
  • LGU sanitary/plumbing permit covering the grease trap before the sewer or septic connection
Have a floor plan already? Send it with the seating count and cooking equipment list and we'll scope the kitchen M&E separately from the front-of-house fit-out. Talk to us about your kitchen fit-out →

Why the Uplift, Not Just a Bigger Number

The published bands below are the same ones AEDO cites for office and clinic fit-outs, because no market source has published a kitchen-specific rate for the Philippines. What changes for a restaurant kitchen isn't the base finish rate, it's the systems layered on top: a dedicated gas line from an outdoor cylinder bank or bulk tank, an exhaust hood sized to the cook line with makeup air to replace what it pulls out, heavier water and floor-drain rough-in than any office needs, and a grease trap ahead of the drainage connection. That's why a full-cook kitchen should be priced toward the top of a band, or above it once the hood, gas line and grease trap are quoted as separate mechanical and plumbing scopes.

By finish level₱ per sqmBy location₱ per sqm
Basic / cosmetic10,000–20,000BGC / Makati CBD25,000–45,000+
Mid-range20,000–35,000Ortigas / Mandaluyong20,000–38,000
High-end / premium35,000–45,000+Quezon City / Alabang15,000–32,000
J.I. Raymundo planning range: ₱20,000–35,000/sqmCebu / Clark / Iloilo: 12,000–28,000

AEDO's own estimate for the full-cook uplift is 15 to 25 percent on top of the base band, to cover the exhaust hood and makeup air run, the LPG gas line, and the grease trap and heavier drainage. That figure isn't from Alphabuild or J.I. Raymundo; it's our engineering judgement for the extra scope, and it should be checked against an actual mechanical and plumbing take-off once the cook line is laid out.

Figure: Three Systems an Office Kitchen Never Needs Gas in, air out, grease out — three systems an office kitchen never needs Cylinder bank Fire Safety Clearance required Cook line Exhaust + makeup air Grease trap — before the sewer/septic connection
None of these three are optional and none are cosmetic. The gas line needs its own Fire Safety Clearance, the hood needs makeup air to work, and the grease trap goes in before the drainage line leaves the building.

The Permits, Not Just the Build

An LPG cooking setup, whether it's cylinder bank or bulk tank, needs its own Fire Safety Clearance from the City or Municipal Fire Marshal having jurisdiction, on top of the building's general Fire Safety Inspection Certificate. That's a requirement of RA 9514, the Fire Code of the Philippines, under its 2019 Revised IRR's LPG standards. Cylinders must sit where they won't see excessive temperature rise, physical damage or tampering, and never near open flames — exact storage distances and quantities should be confirmed with the local Fire Marshal rather than assumed from a generic table, since enforcement varies by LGU.

Separately, the cylinders themselves need to conform to PNS 03, the Philippine National Standard for transportable and refillable steel LPG cylinders, and whoever supplies or installs them needs a Safety Compliance Certificate from the DOE or DTI before commercial operation. That's usually the gas supplier's or installer's paperwork to carry, but it's a real approval your project timeline needs to track, not something the fit-out itself designs.

On the plumbing side, the Code on Sanitation of the Philippines (PD 856) sets general requirements for food establishment sanitation and wastewater disposal, and in practice LGU sanitary and plumbing permitting for a food establishment commonly requires a grease trap before kitchen wastewater discharges to the sewer or septic system. See our national plumbing code guide and septic tank sizing guide for how that connects to the rest of the drainage design.

What to Ask a Contractor Before Signing

Is the hood and exhaust priced as its own line item, sized to the actual cook line and BTU load, not a generic allowance. Who's pulling the Fire Safety Clearance for the LPG and is that timeline built into the project schedule. Where does the grease trap sit in the drainage run, and is it upstream of every fixture that can carry fats and oils. A change of use into a restaurant also triggers a building permit alteration; see our fit-out permit guide for that process.

Where These Figures Come From

Finish-level and location bands are from Alphabuild's 2026 Manila office fit-out guide; the ₱20,000–35,000 planning range is from J.I. Raymundo Builders' 2026 guide. Both are published for office fit-outs, used here as a floor for a kitchen. The 15–25% full-cook uplift is AEDO's own estimate, not a cited market figure. LPG and fire figures are from RA 9514's 2019 Revised IRR and DTI's PNS 03; the grease-trap requirement is general practice under PD 856, not a specific section citation.

Frequently Asked Questions

What makes a commercial kitchen fit-out different from an office fit-out?

The added mechanical, electrical and plumbing scope specific to cooking: an LPG gas line and storage, an exhaust hood and makeup air, heavier water and drainage rough-in, and a grease trap. That extra scope pushes cost toward the higher end of standard fit-out ranges.

Do I need a separate permit for the LPG installation in my restaurant kitchen?

Yes. RA 9514, the Fire Code of the Philippines, and its 2019 Revised IRR set LPG standards under Sec. 10.3.7.8, and any installation, storage or handling of LPG needs its own Fire Safety Clearance from the City or Municipal Fire Marshal, on top of the building's general Fire Safety Inspection Certificate. Cylinders also need a DOE or DTI Safety Compliance Certificate and must conform to PNS 03, the Philippine National Standard for transportable and refillable steel LPG cylinders.

Do commercial kitchens need a grease trap?

In practice, yes. LGU sanitary and plumbing permitting for a food establishment commonly requires a grease trap before kitchen wastewater reaches the sewer or septic system, to keep fats, oils and grease out of the drainage line. See our plumbing code and septic tank sizing guides for the technical side.

How much does a commercial kitchen fit-out cost in the Philippines?

The same published 2026 bands used for offices and clinics apply as a starting point: Alphabuild's guide puts Manila fit-outs at roughly 10,000 to 20,000 pesos per square metre basic, 20,000 to 35,000 mid-range and 35,000 to 45,000 or more high-end, and J.I. Raymundo Builders gives a planning range of 20,000 to 35,000. A full-cook kitchen typically lands toward the higher end of those bands because of the extra LPG, exhaust and grease-trap scope.

Sources

Published references used in this article. Links open in a new tab.

  • Office Fit-Out Costs in Manila: What to Budget in 2026, Alphabuild, secondary source. Tier and location cost bands.
  • How Much Does an Office Fit-Out Cost Per SQM in Manila? (2026 Guide), J.I. Raymundo Builders, secondary source. Planning range for commercial fit-outs.
  • Republic Act No. 9514, the Fire Code of the Philippines, Revised IRR (2019), Sec. 10.3.7.8 — LPG Standards. Fire Safety Clearance requirement for LPG installation, storage and handling.
  • DTI Bureau of Philippine Standards — PNS 03, Transportable and Refillable Steel Cylinders for LPG. Cylinder standard and DOE/DTI Safety Compliance Certificate requirement.
  • Code on Sanitation of the Philippines (Presidential Decree No. 856). General reference for food establishment sanitation and wastewater disposal; not cited to a specific section number here.

Fit-out cost bands are published figures for office fit-outs, used here as a floor for a commercial kitchen. The full-cook uplift is AEDO's own estimate, not a cited market figure. This guide does not cover food-business or health-permit licensing.

Scope Your Kitchen Fit-Out Before You Quote It

Get the front-of-house fit-out and the kitchen M&E scoped separately, with the LPG and grease-trap permits mapped against your project timeline.

  • Fit-out estimate by trade, kitchen M&E scoped separately
  • MEPFS design for the exhaust, gas line and drainage
  • Permit tracking: building alteration, Fire Safety Clearance, sanitary permit
  • Design nationwide; design-build construction in Negros Oriental only
